Lake McQueeney Dam Construction Update

July 22, 2025

7-22-2025 Monthly Project Update

The Board of Directors for Lake McQueeney Water Control and Improvement District No. 1 (LMWCID 1, or “the District”) would like to provide residents an update on the work performed so far at the dam for the Lake McQueeney Spillgate Replacement and Dam Armoring Project.

Schedule Status:

Due to impacts from the June flooding event, the revised substantial completion date is December 9, 2025. This does not include impacts from the July flooding events. Assessment and impacts from July flooding are being assessed.

Current Work Status:

  • Bay 2 concrete spillway slab 4.2 – Completed

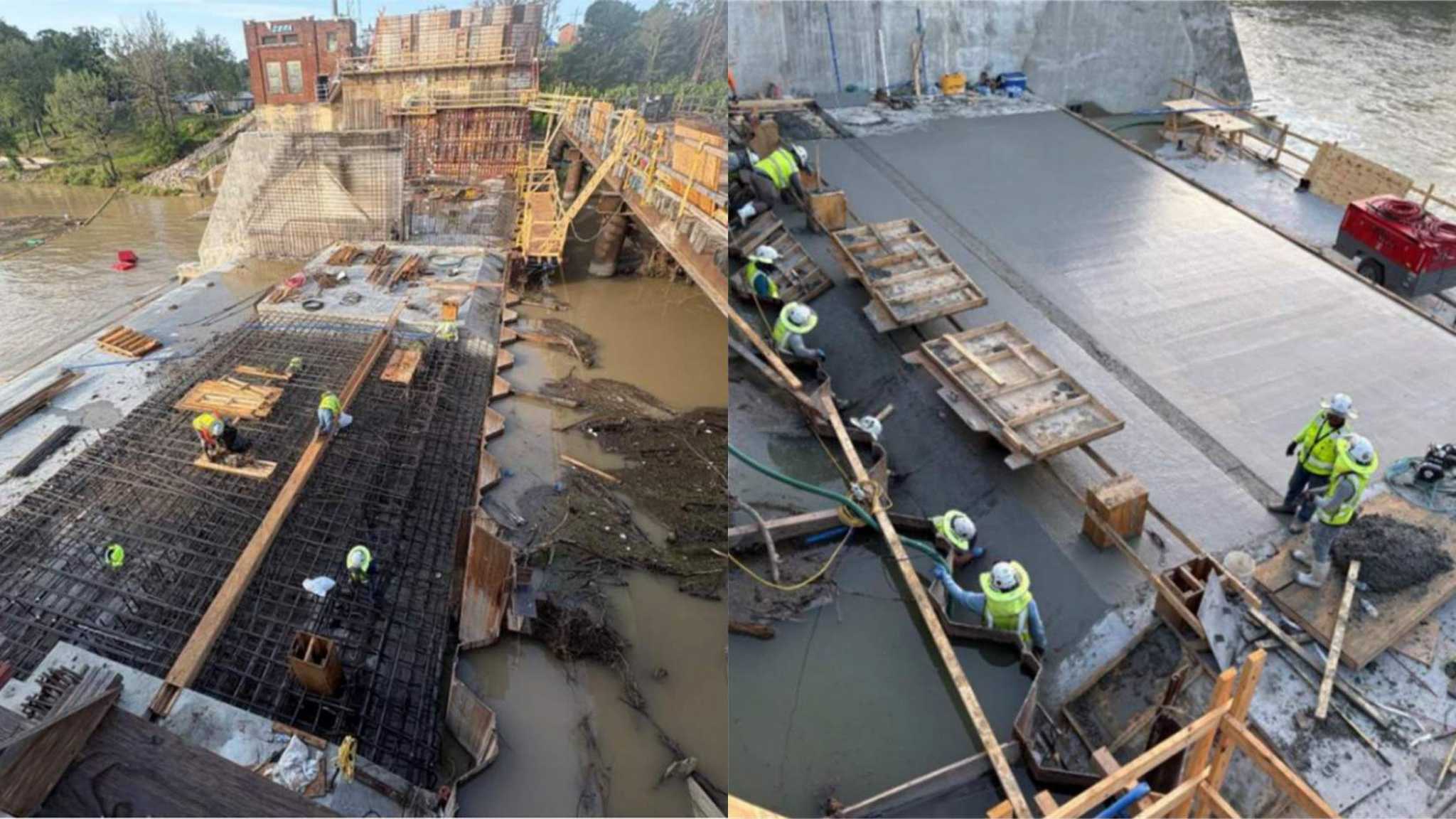

  • South abutment concrete lift 1 – Completed

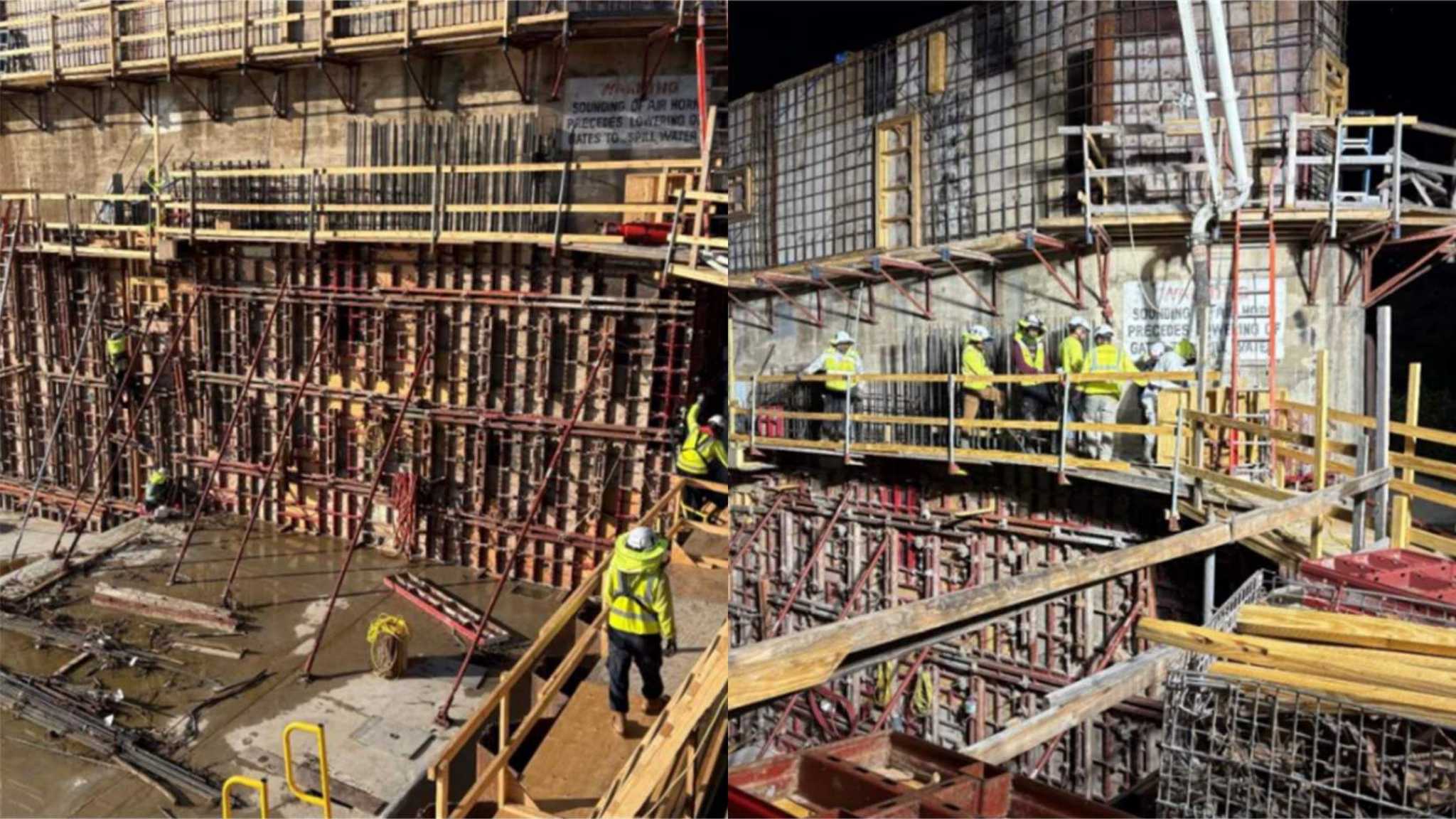

  • South abutment concrete lift 2 – Ongoing

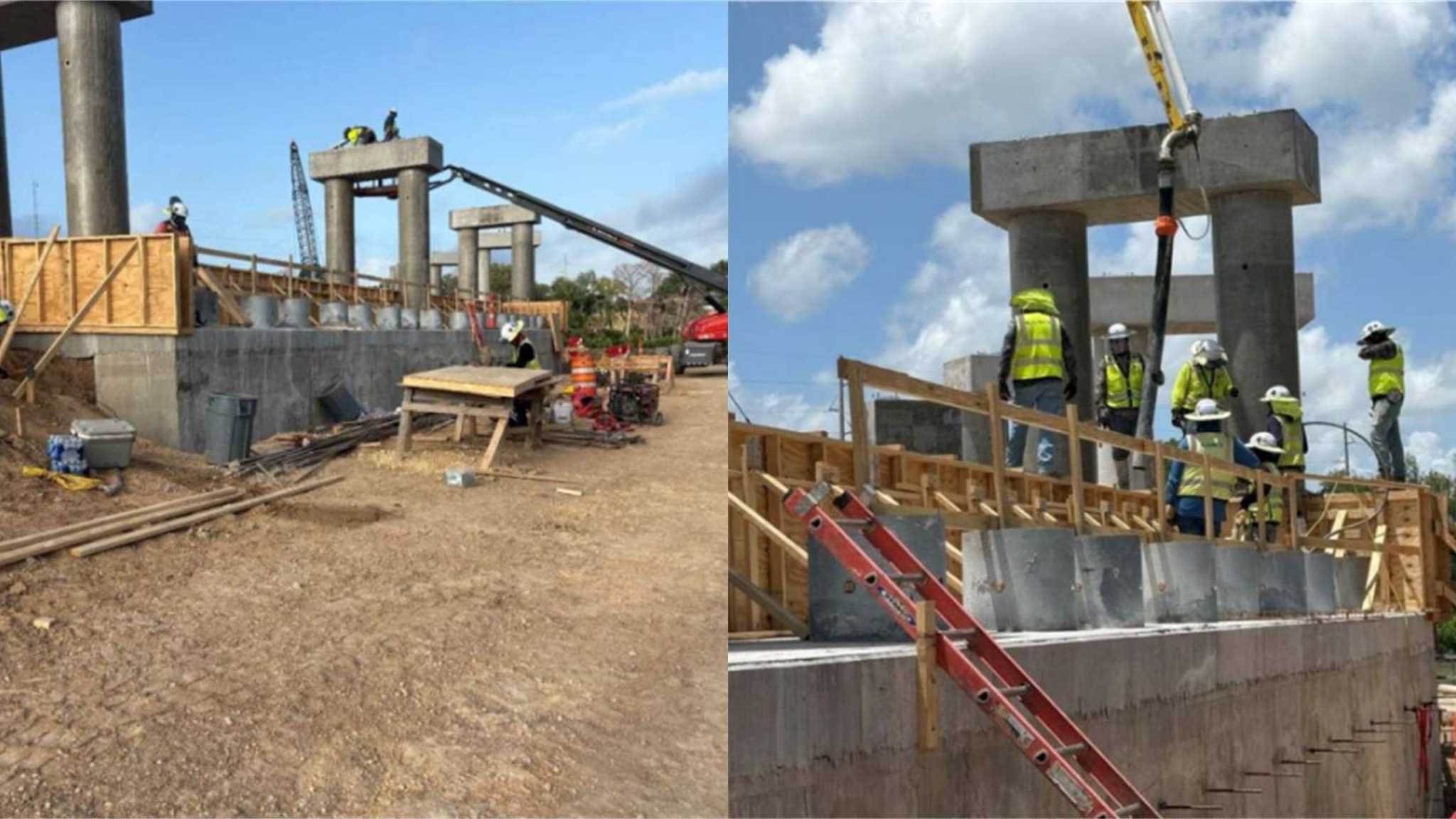

  • Pier 2 – Ongoing

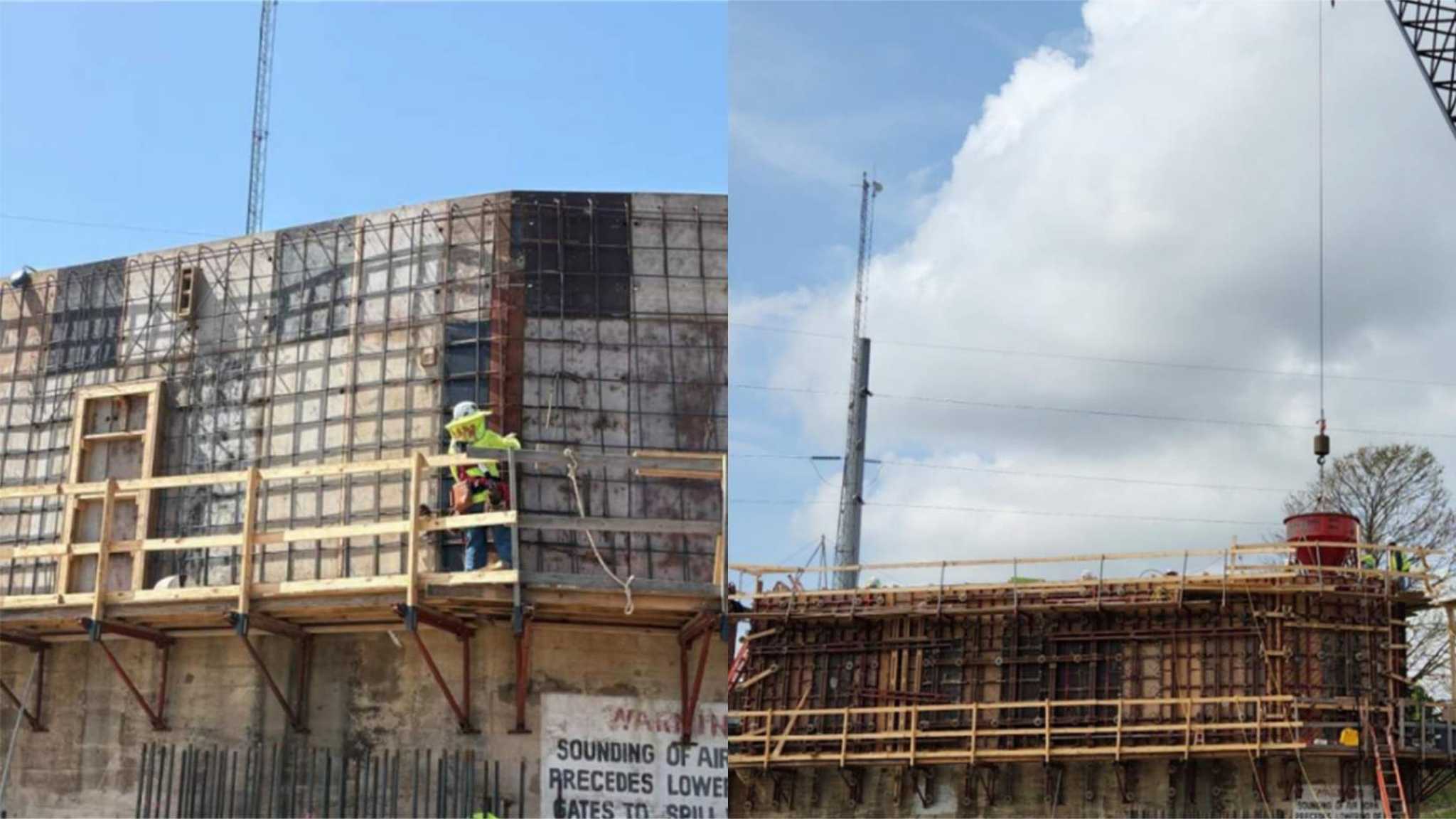

  • McQueeney control building concrete walls – completed

  • Stop log storage foundation – Completed

  • Generator – Completed

  • North Embankment dam armoring – Ongoing

  • South Embankment dam armoring – Ongoing

Upcoming work:

  • Pier 2 concrete lift 1

  • Bay 3 & 2 hinge support slab

  • South abutment concrete lift 2 & 3

  • Set HPU

  • Control building modifications and concrete roof

  • Pier 2 concrete lift 2 & 3

  • North and South embankment dam armoring earthwork and concrete placements

Steel-Fab, Inc (steel gate manufacturer)

  • First section of Bay 3 expected first week of August

If residents have additional questions regarding the Lake McQueeney Spill gate Replacement and Dam Armoring Project, please use the Contact Us form to submit your inquiries.
