5-12-2025 Monthly Project Update
The Board of Directors for Lake McQueeney Water Control and Improvement District No. 1 (LMWCID 1, or “the District”) would like to provide residents an update on the work performed so far at the dam for the Lake McQueeney Spillgate Replacement and Dam Armoring Project.
Schedule Status:
Substantial completion date is set for early November 2025
Current Work Status:

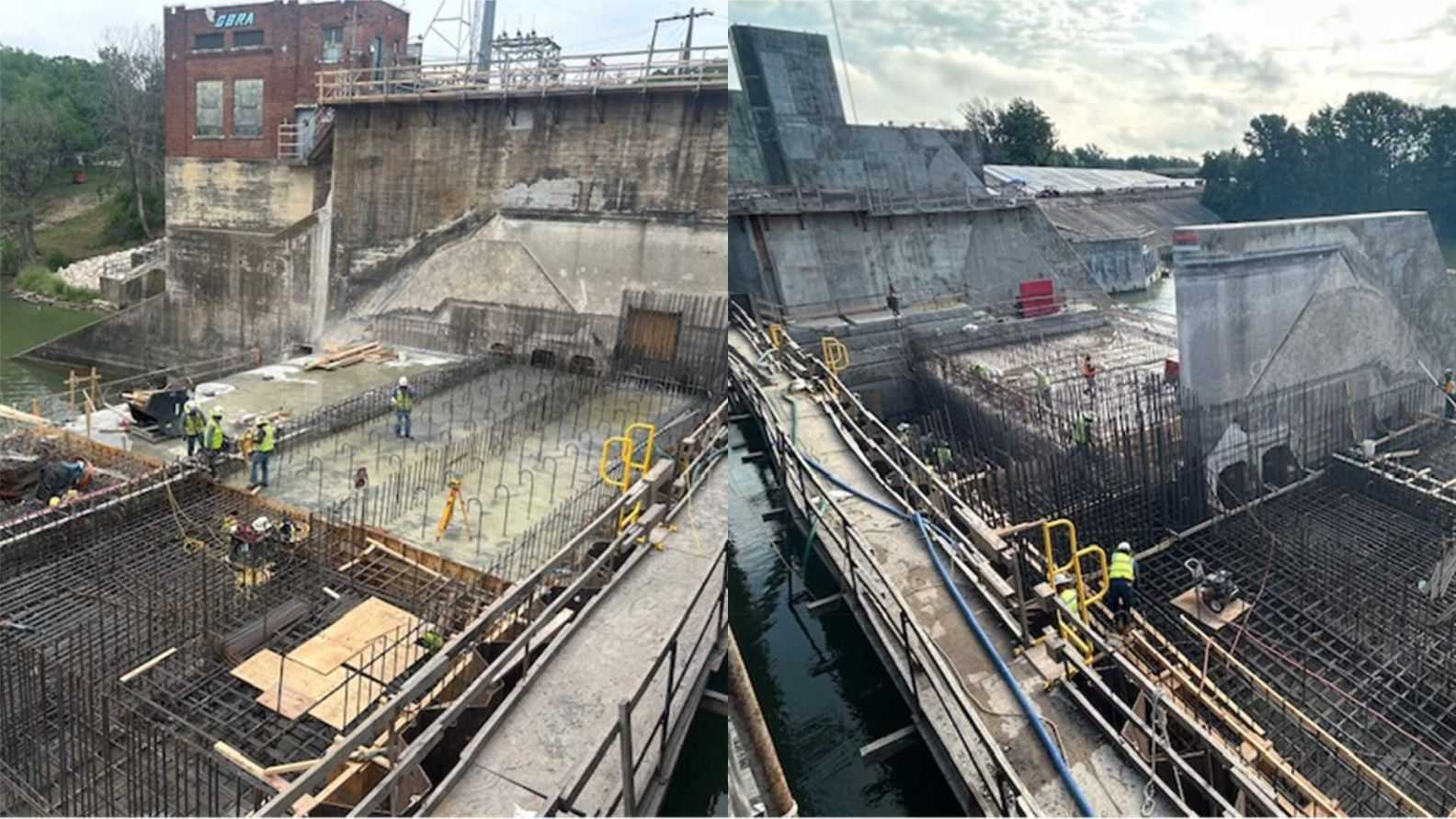

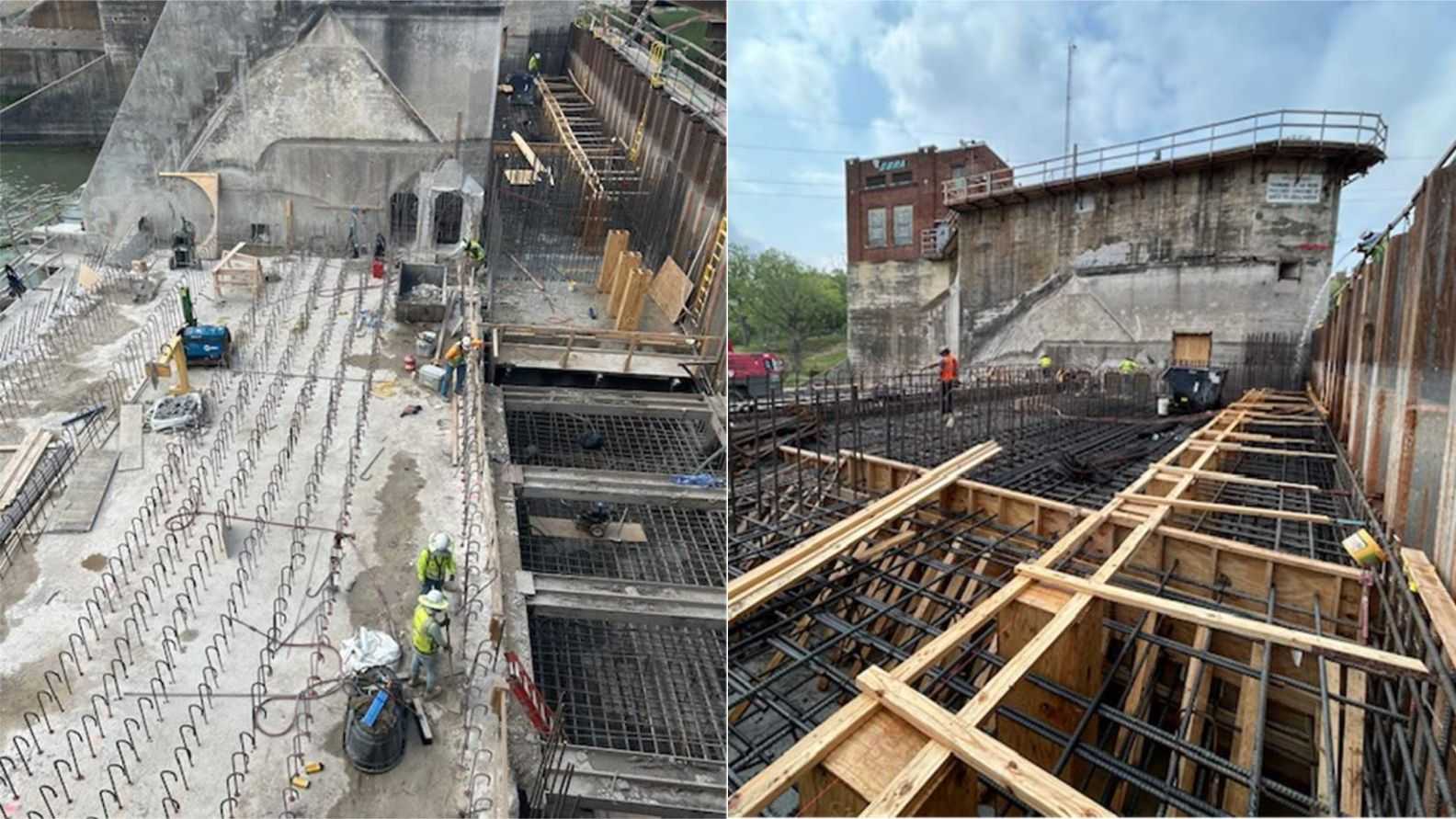

- Bay 3 concrete foundation 2nd lift – Completed
- Bay 3 concrete spillway slab 3.1 lift - Completed
- Bay 3 concrete spillway slab 3.2 & 3.3 – Started
- Bay 3 concrete spillway slab 4.1 - Started
- Bay 2 concrete foundation 1st lift - Completed
- Bay 2 concrete foundation 2nd lift – Started

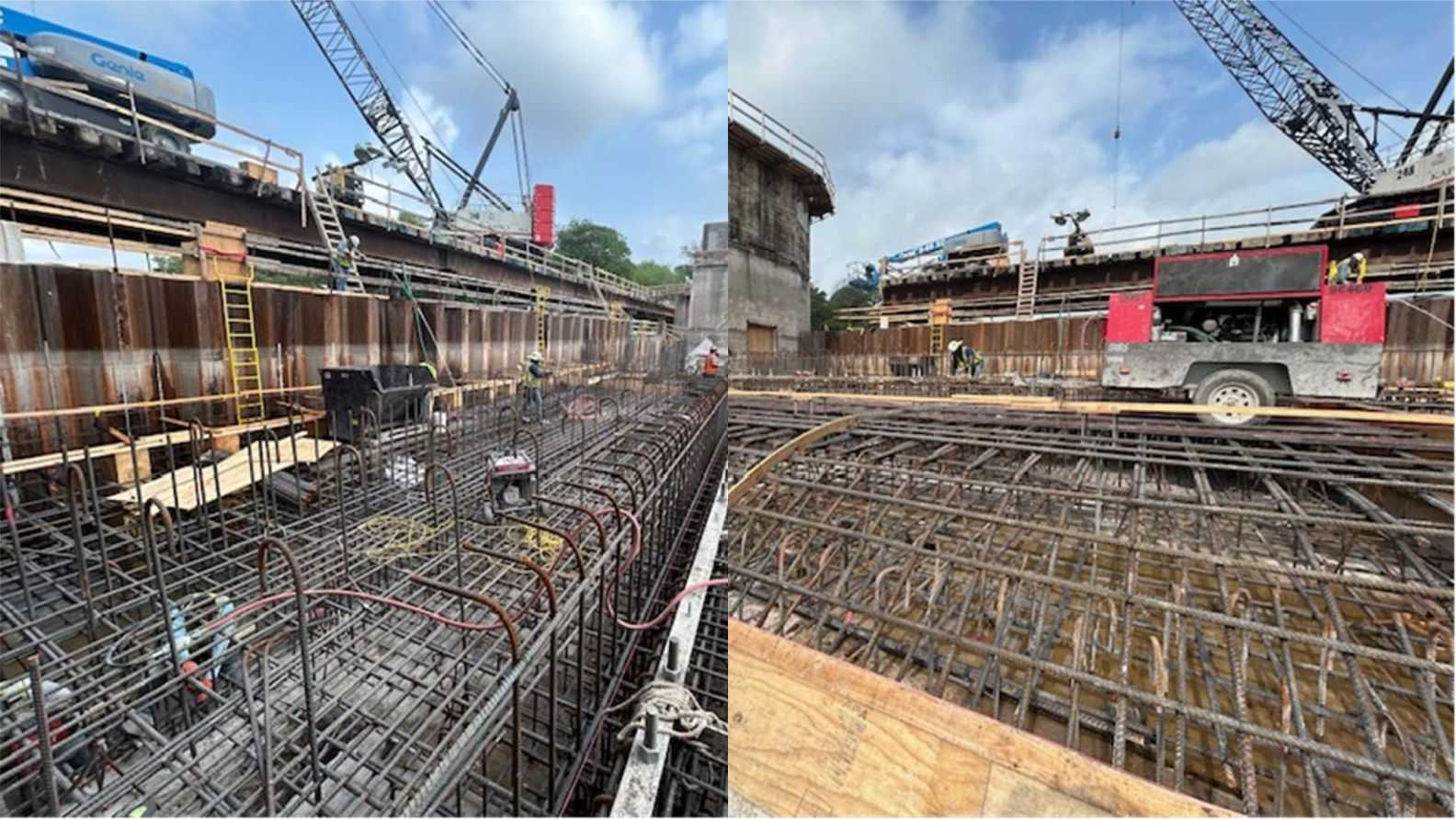

- McQueeney control building concrete – Started

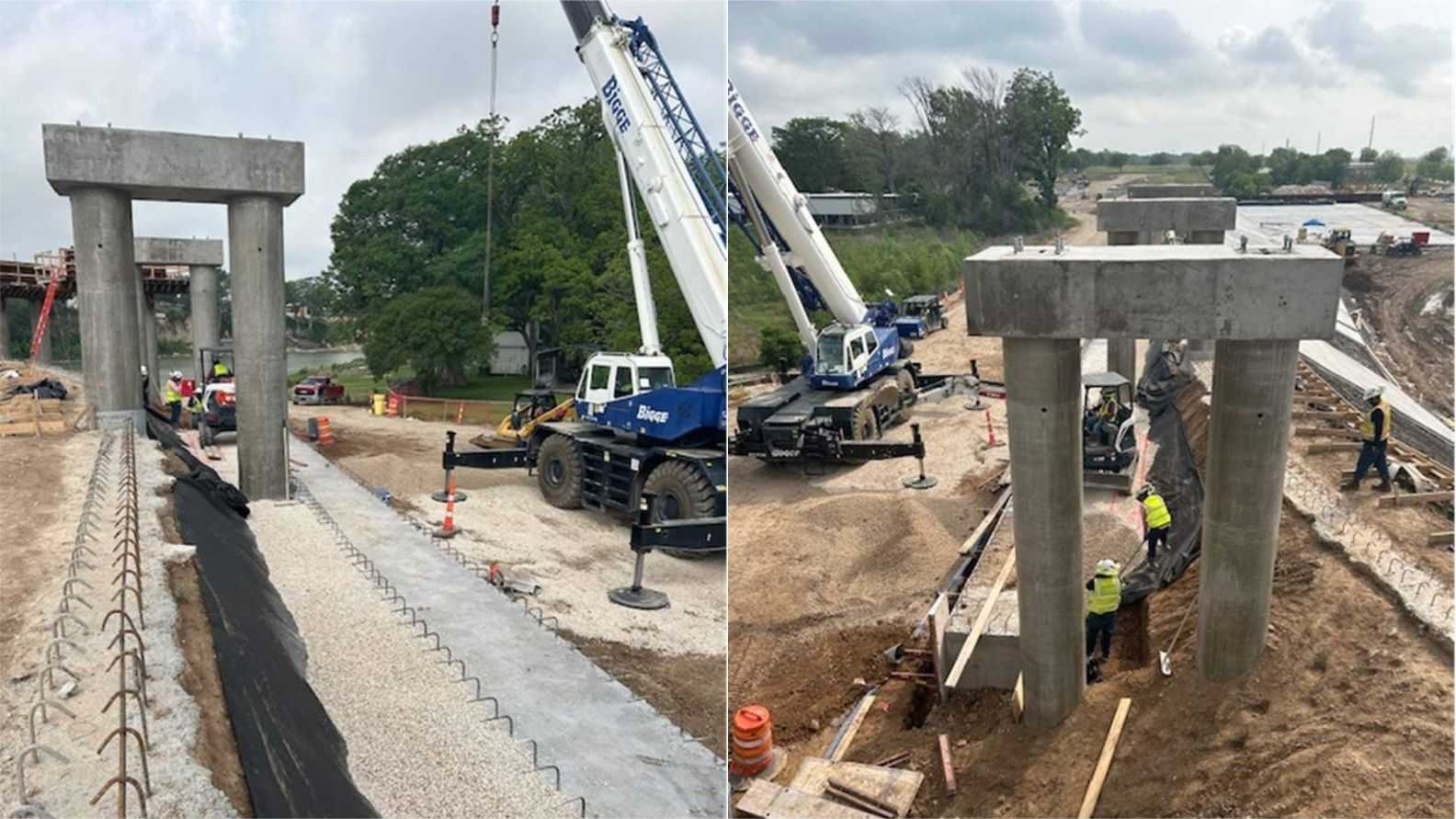

- Maintenance bridge bent caps – Completed

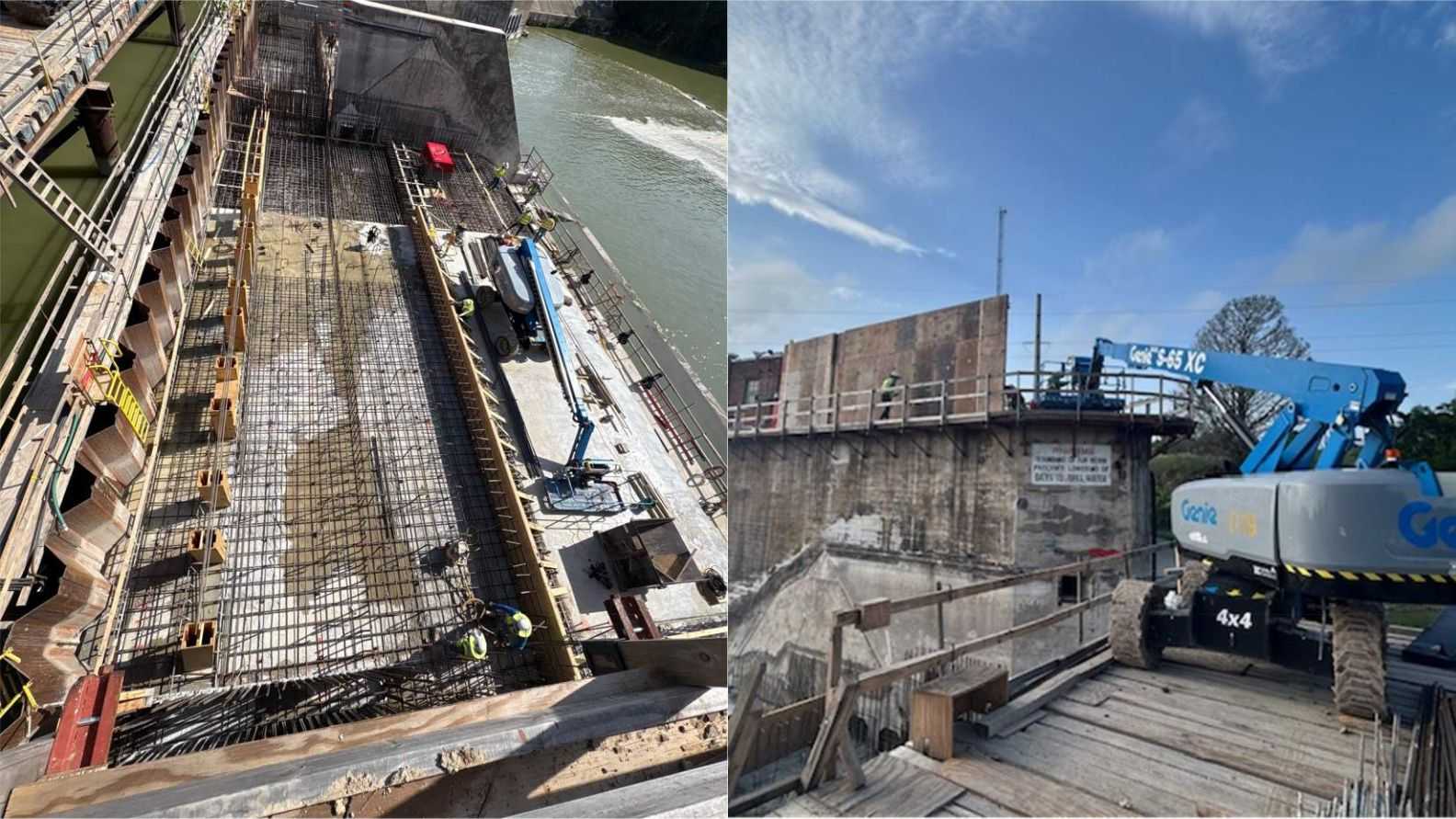

- Maintenance bridge steel spans assembly –Ongoing
- Stop log storage foundation – Ongoing
- North Embankment dam armoring – Ongoing
- South Embankment dam armoring – Restarted
Upcoming work:
- Bay 3 concrete spillway slab placement 3.2
- Bay 3 concrete spillway slab placement 3.3
- Bay 2 concrete foundation 2nd lift
- Bay 2 concrete spillway slab lift 3
- Bay 3 concrete spillway slab 4.1
- Bay 3 concrete spillway slab 4.2
- South abutment concrete lift 1
- Control building modifications and concrete walls
- North and South embankment dam armoring earthwork and concrete placements
Steel-Fab, Inc (steel gate manufacturer)

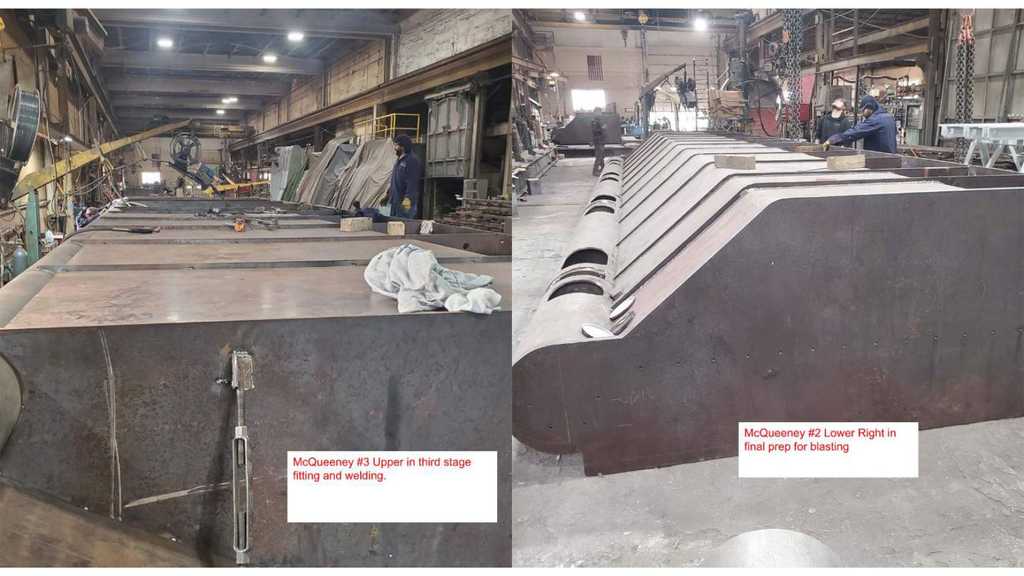

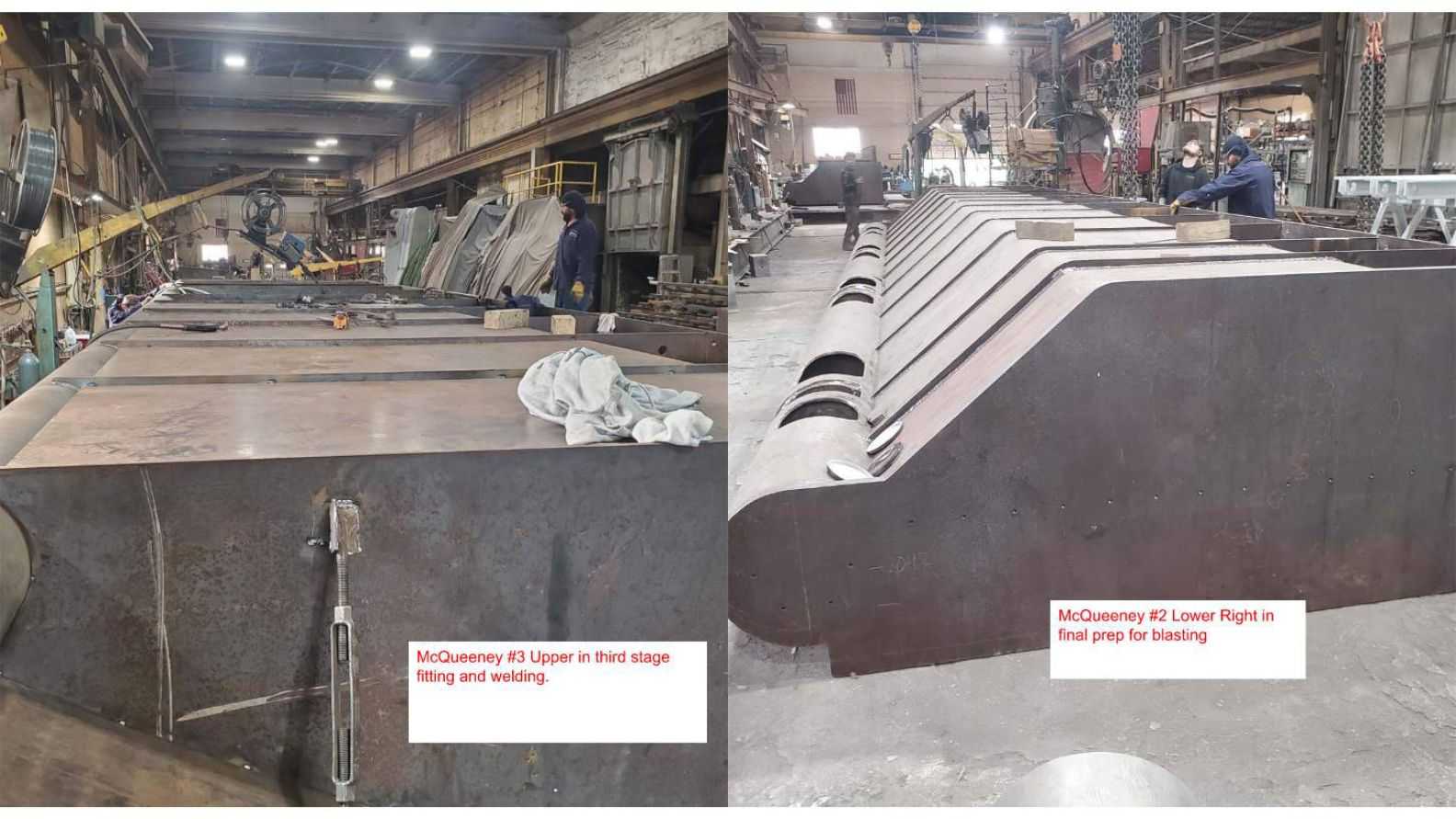

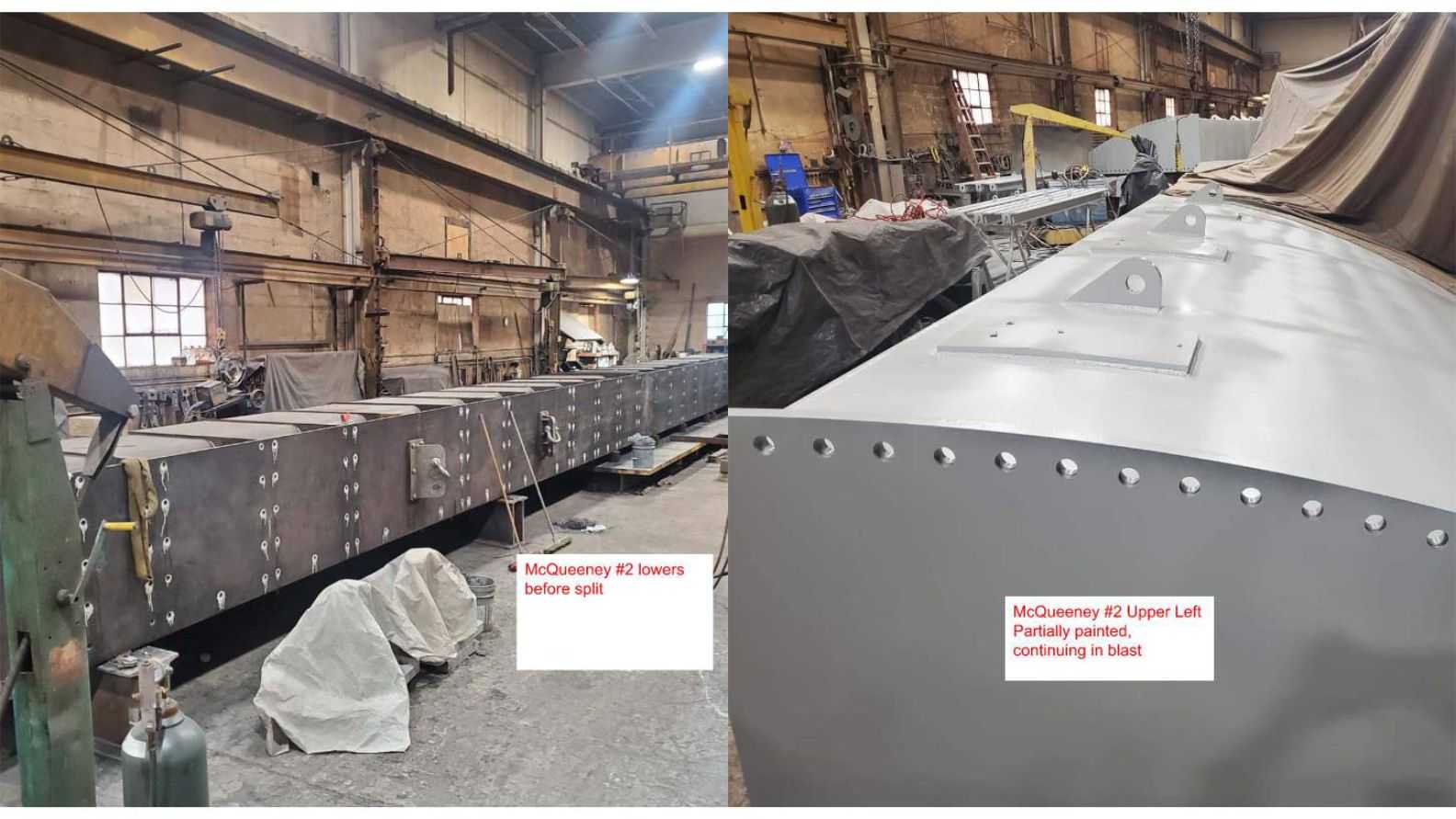

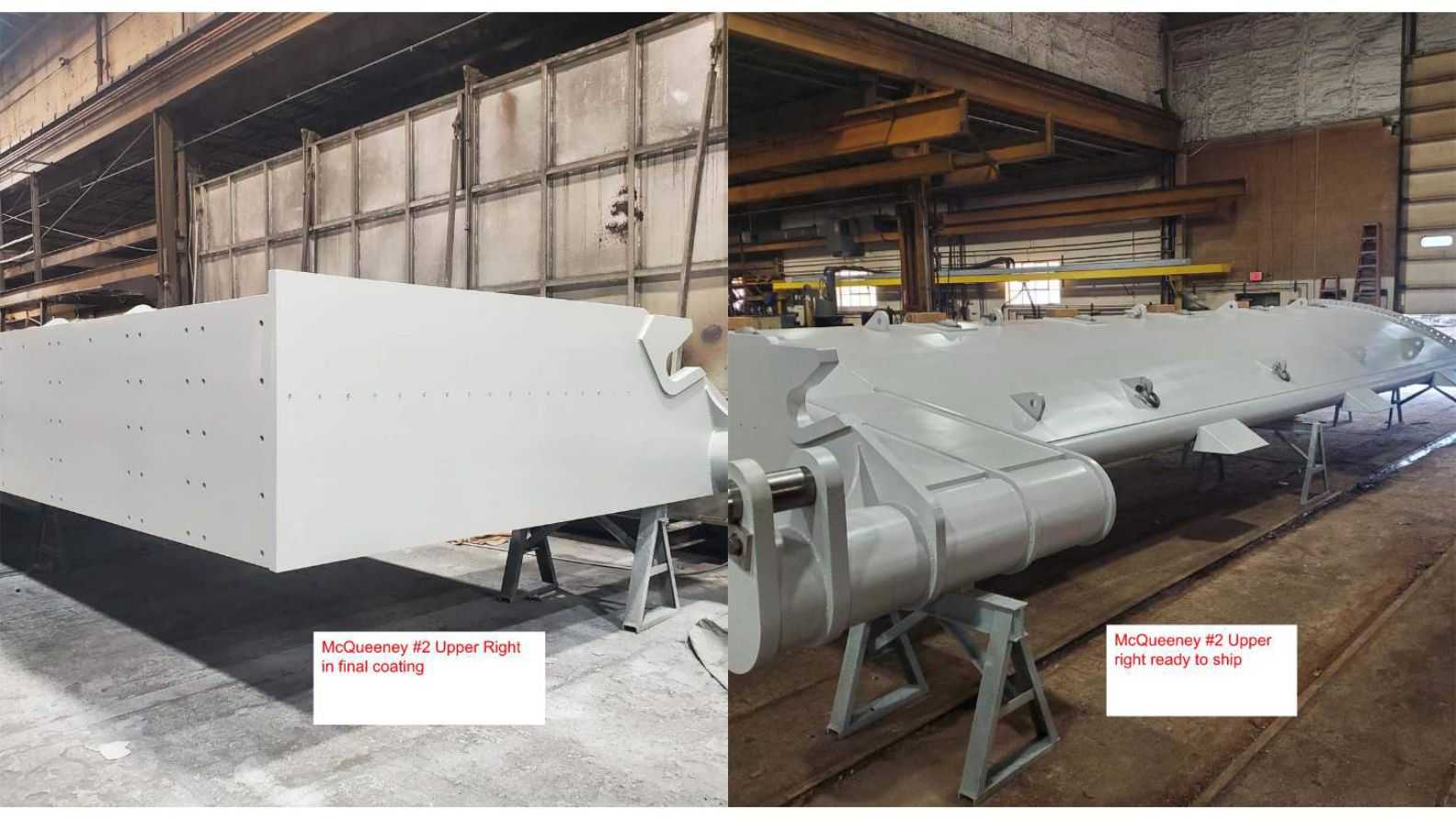

- Gate manufacturing ongoing
- Targeting delivery through end of July
If residents have additional questions regarding the Lake McQueeney Spill gate Replacement and Dam Armoring Project, please use the Contact Us form to submit your inquiries.
